Lifting operations · handover control

Crane Handover & Authority Approval Gate Tracker

The crane passes gates, not paperwork. Erection, independent certification and operating release are separate decisions, and the exact plot — not the emirate — decides the authority stack. Track the ten Dubai and Abu Dhabi approval and certification milestones here, then download the controlled workbooks for the project record.

Abu Dhabi rows follow published ADM Circular 001/2021 and the ENAS inspection framework. Dubai rows are written as confirmation gates — obtain the current Dubai Municipality, DCAA, Civil Defence, free-zone or developer condition for the exact plot before releasing any gate.

Project and crane dashboard

Release status

Approval gates

10

Released

0/10

Open holds

0

Crane release

Not yet

Approval and certification milestones

M-01JurisdictionOpen

Exact plot and authority stack confirmed

Dubai authority path
Confirm the Dubai Municipality route and whether DCAA, Civil Defence, a free zone, port or master developer adds to or replaces it.
Abu Dhabi authority path
Confirm the ADM / DMT route and whether ADPHC / ADOSH-SF, airport safeguarding, a developer or port adds further conditions.
Required controlled evidence
Written jurisdiction and authority matrix with named contacts for each interface.
Hold / release criterion
No mobilisation until the responsible authority stack is confirmed in writing.
Responsible lead
Project manager
Independent verifier
HSE / consultant
M-02EngineeringOpen

Engineering and configuration pack accepted

Dubai authority path
Approved foundation, ties, configuration, load charts and erection design for the actual machine and plot.
Abu Dhabi authority path
The ADM permit route uses approved MEPS drawings; the configuration and boundary solution must match those drawings.
Required controlled evidence
OEM manual, general arrangement, foundation and tie calculations, component weights, load charts and the erection / dismantling design.
Hold / release criterion
No erection with an unapproved or mismatched configuration.
Responsible lead
Temporary works / structural engineer
Independent verifier
Appointed person
M-03ApprovalsOpen

Authority permits and NOCs issued and current

Dubai authority path
Current Dubai Municipality condition plus the DCAA / airport, Civil Defence and developer or free-zone NOCs for the exact location and height.
Abu Dhabi authority path
ADM / DMT tower-crane installation permit and approved drawings, including self-erecting cranes.
Required controlled evidence
Permits, NOCs, a conditions register, approval validity dates and the drawing revision they approve.
Hold / release criterion
All required permits and NOCs current before erection starts.
Responsible lead
Project manager
Independent verifier
Consultant / HSE
M-04ErectionOpen

Pre-erection readiness and subcontractor handover

Dubai authority path
Site and urban-interface controls confirmed against the approved logistics, traffic and public-protection arrangements.
Abu Dhabi authority path
The erection company verifies the permit and that installation follows the approved drawings and plot boundary.
Required controlled evidence
Competence list, support-crane and rigging certificates, logistics and exclusion-zone plan, rescue plan, weather limits and the toolbox-briefing record.
Hold / release criterion
No start until the pre-erection hold point is signed and the crew is briefed.
Responsible lead
Erection supervisor
Independent verifier
Appointed person / HSE
M-05ErectionOpen

Erection and commissioning hold point closed

Dubai authority path
Complete the approved erection and record structural, electrical, access and safety-device commissioning results.
Abu Dhabi authority path
The crane must remain within the plot boundary and present zero collision risk in any configuration, including out of service.
Required controlled evidence
Erection records, pin / bolt / torque and tie controls, earthing and electrical checks, brake, limit, SLI/RCI, anti-two-block, anemometer and anti-collision test results.
Hold / release criterion
No operation before defects are closed and the technical file is complete.
Responsible lead
Erection subcontractor
Independent verifier
Engineer / HSE
M-06CertificationOpen

Independent inspection body accepted

Dubai authority path
Confirm accreditation, scope and the authority or client acceptance of the nominated inspection body.
Abu Dhabi authority path
Approved third-party annual crane inspection; verify the provider is on the accepted route before appointment.
Required controlled evidence
Accreditation certificate and scope, authority or client acceptance, named inspector and authorised signatory.
Hold / release criterion
No examination or test by a non-accepted or out-of-scope provider.
Responsible lead
Crane owner
Independent verifier
Project HSE / consultant
M-07CertificationOpen

Thorough examination and required tests passed

Dubai authority path
Tests follow the OEM manual, the inspection body procedure and the current authority or project condition — never a generic proof-load value.
Abu Dhabi authority path
The ENAS framework requires functional, overload and safety-device testing within the inspection-body scope.
Required controlled evidence
Approved test method or RAMS, calibrated instruments, the tested configuration, results and the defect and action log.
Hold / release criterion
No release until the examination passes and every defect or action is closed.
Responsible lead
Inspection body
Independent verifier
Appointed person / HSE
M-08CertificationOpen

Certificate and report accepted

Dubai authority path
Confirm certificate completeness, restrictions and expiry against the Dubai route in force.
Abu Dhabi authority path
ADM requires annual approved third-party inspection; crane and lifting-gear certification must be current and traceable.
Required controlled evidence
Unique certificate or report showing crane serial, location and configuration, test type and outcome, restrictions, signatory and next-due date.
Hold / release criterion
No operational handover with a missing, incorrect, expired or crane-mismatched certificate.
Responsible lead
Crane owner
Independent verifier
Principal contractor / consultant
M-09HandoverOpen

Operational handover to the principal contractor

Dubai authority path
Accept the maintenance plan, competent operators, daily and weekly records and the emergency and weather procedures.
Abu Dhabi authority path
Daily and weekly competent-person checks and monthly specialist third-party maintenance must be in place and evidenced on request.
Required controlled evidence
Signed handover certificate, technical file, maintenance plan, competence records, weather and anti-collision procedures and the emergency plan.
Hold / release criterion
Every named signatory releases the crane before it operates.
Responsible lead
Principal contractor
Independent verifier
Appointed person / HSE
M-10Change controlOpen

Change, repair and incident control

Dubai authority path
Reopen the affected approvals and certification on major repair, configuration, tie or height change, or after an incident.
Abu Dhabi authority path
Reassess and re-approve; notify and investigate according to the ADOSH-SF seriousness classification and the concerned SRA route.
Required controlled evidence
Change record, revised design and RAMS, re-inspection or re-test report, authority notification and the written release.
Hold / release criterion
Hold the affected crane until a written release is issued.
Responsible lead
Project manager
Independent verifier
HSE / consultant

Entries are saved in this browser only. Use the workbook downloads for a shared, auditable project copy.

Subcontractor handover stages

Each stage in the handover control workbook has its own acceptance criteria, evidence reference and accept / hold disposition.

Authority, permit and inspection-body gate

Before any crane commitment or mobilisation.

  • Exact plot route confirmed in writing — municipality, free zone, port, master developer.
  • Current erection or use permit / NOC, building and temporary-works approval.
  • Aviation, Civil Defence, utility and developer conditions captured in a conditions register.
  • Inspection body accreditation, scope and authorised signatory verified and accepted.

Pre-erection subcontractor handover

Before components are delivered or assembled.

  • Signed subcontract, scope and role matrix, crane ownership and 24-hour escalation contacts.
  • Manufacturer configuration, approved foundation and base design, ground and geotechnical confirmation.
  • Mast, tie and climbing design, maximum height, jib, counter-jib, ballast and current load charts.
  • Erection / dismantling RAMS: OEM sequence, component weights, support-crane plan, rigging, exclusion zone, traffic and public interface, weather limits, dropped-object controls and rescue plan.
  • Personnel competence verified for erection crew, operator, rigger, signaller, maintenance and rescue roles.

Erection and commissioning

At each erection hold point and before third-party testing.

  • Permit, approved drawings and the physical crane configuration match — serial, height, jib, ties.
  • Component identity, pins, bolts, torque, tie installation and survey recorded.
  • Safe access, earthing, isolation, cab, lighting and fire / emergency readiness confirmed.
  • Brakes, limits, SLI / RCI, anti-two-block, anemometer and anti-collision or zoning tested and recorded.
  • Defects raised at commissioning closed, or the crane is quarantined and re-inspected.

Third-party examination and load-test certification

Before, during and after independent examination.

  • Inspection body accepted by the authority or client, with scope covering this crane type and test.
  • Test method taken from the OEM manual, inspection-body procedure and authority condition — no generic proof load.
  • Calibrated test instruments and recorded test configuration, radius and load.
  • Certificate identifies crane model, serial, configuration and location, with restrictions, signatory and next-due date.
  • Failed or conditional results hold operation until closed out and re-tested.

Operational handover to the principal contractor

Only after commissioning and independent certification are complete.

  • Technical file transferred: manuals, permits and NOCs, engineering, configuration records, load charts and certificates.
  • Maintenance plan accepted with named provider, daily / weekly / monthly controls and the defect and quarantine process.
  • Operator, rigger and signaller competence, weather limits, anti-collision, boundary and aviation controls accepted.
  • Emergency, rescue and severe-weather procedures briefed with named responders.
  • Handover certificate signed by every release authority before the crane operates.

Pre-dismantling handover

Before tie removal, mast reduction or dismantling starts.

  • Dismantling authorisation covering the current configuration, tie-removal sequence and support-crane plan.
  • Authority, developer and aviation conditions re-confirmed for the dismantling window.
  • Exclusion zone, road, public and neighbour interface controls re-issued.
  • Weather limits for dismantling stated and lower than the operating limits where the OEM requires it.

Dismantling close-out and subcontractor release

Before the subcontractor demobilises.

  • Dismantling records, component condition reports and damage or defect register handed over.
  • Foundation, anchor and tie make-good completed and structurally accepted.
  • Permits and NOCs formally closed with the issuing authority where required.
  • Final documentation pack archived against the project record index.

Incident and non-compliance notification

A near miss can reopen every gate. Notification timing is published for Abu Dhabi and must be confirmed against the live permit condition in Dubai.

JurisdictionEventTimingRoute
Abu Dhabi (ADOSH-SF)PublishedWork-related fatalityForm G notification within 24 hoursNotify the concerned Sector Regulatory Authority using the ADOSH-SF incident notification mechanism. ADPHC ADOSH-SF Mechanism 11.0 — Incident Notification
Abu Dhabi (ADOSH-SF)PublishedSerious dangerous occurrence, serious injury or serious illnessNotify within a maximum of three working daysNotify the concerned SRA. Never delay Police, Civil Defence, ambulance or immediate safety actions while preparing the notification. ADPHC ADOSH-SF Mechanism 11.0 — Incident Notification
Abu Dhabi (construction subcontractor)PublishedAny notifiable event involving a subcontractorImmediately to the principal contractorReporting responsibility follows the nominated-entity hierarchy — the principal contractor carries the notification duty upward. ADPHC ADOSH-SF Mechanism 11.0 — Incident Notification
Dubai mainland or special zoneConfirm locallyCrane near miss, dropped object, structural or safety-device eventConfirm the timing in the live permit and authority conditionStop and secure, notify the principal contractor, client and developer, then use the current permit and authority contacts recorded in the project matrix.
Dubai Development Authority areasConfirm locallySite accident within DDA jurisdictionPer the current DDA circular in forceDDA provides site accident reporting and investigation services; current circulars include accident-notification requirements — obtain the version applicable to the plot. Dubai Development Authority — construction services
Aviation, public or emergency interfaceConfirm locallyAny event affecting airspace, public areas or requiring rescueImmediateFollow DCAA / airport, Civil Defence, Police and ambulance and developer procedures without waiting for internal paperwork.

Events that reopen the gates

  • Structural concern, dropped load, uncontrolled crane movement or a safety-device event — stop, isolate, protect people, preserve evidence and escalate.
  • Missing or expired permit or certificate, or a configuration that does not match the approval — stop and quarantine until a corrected approval and written release exist.
  • Major repair, or a change of configuration, tie arrangement or height — reopen the engineering, authority, inspection and handover gates.
  • Change of erection subcontractor or inspection provider — re-verify competence, scope and acceptance before any further work.

Controlled handover pack

Crane Subcontractor Handover ChecklistWord

The full written checklist across seven handover stages, from pre-mobilisation to dismantling close-out, with the authority and certification baseline for Dubai and Abu Dhabi.

Crane Subcontractor Handover Control WorkbookExcel

One tab per handover stage with acceptance criteria, evidence reference, submitted-by, verified-by and an accept / hold disposition that rolls up from the project dashboard.

Crane Approval and Certification Milestone TrackerExcel

The M-01 to M-10 milestone tracker plus the authority and NOC matrix, third-party certificate register, incident notification matrix and reference log.

Crane Handover Incident Reporting and Authority Notification ProcedureWord

Working procedure for near misses, non-compliance and serious crane events, with the escalation ladder, evidence preservation duties and the authority notification routes.

Appendix A — Crane Approval WorkflowWord

The narrative appendix behind the workflow diagram: mobilisation trigger, the two authority branches, the erection hold point, independent certification and operational release.

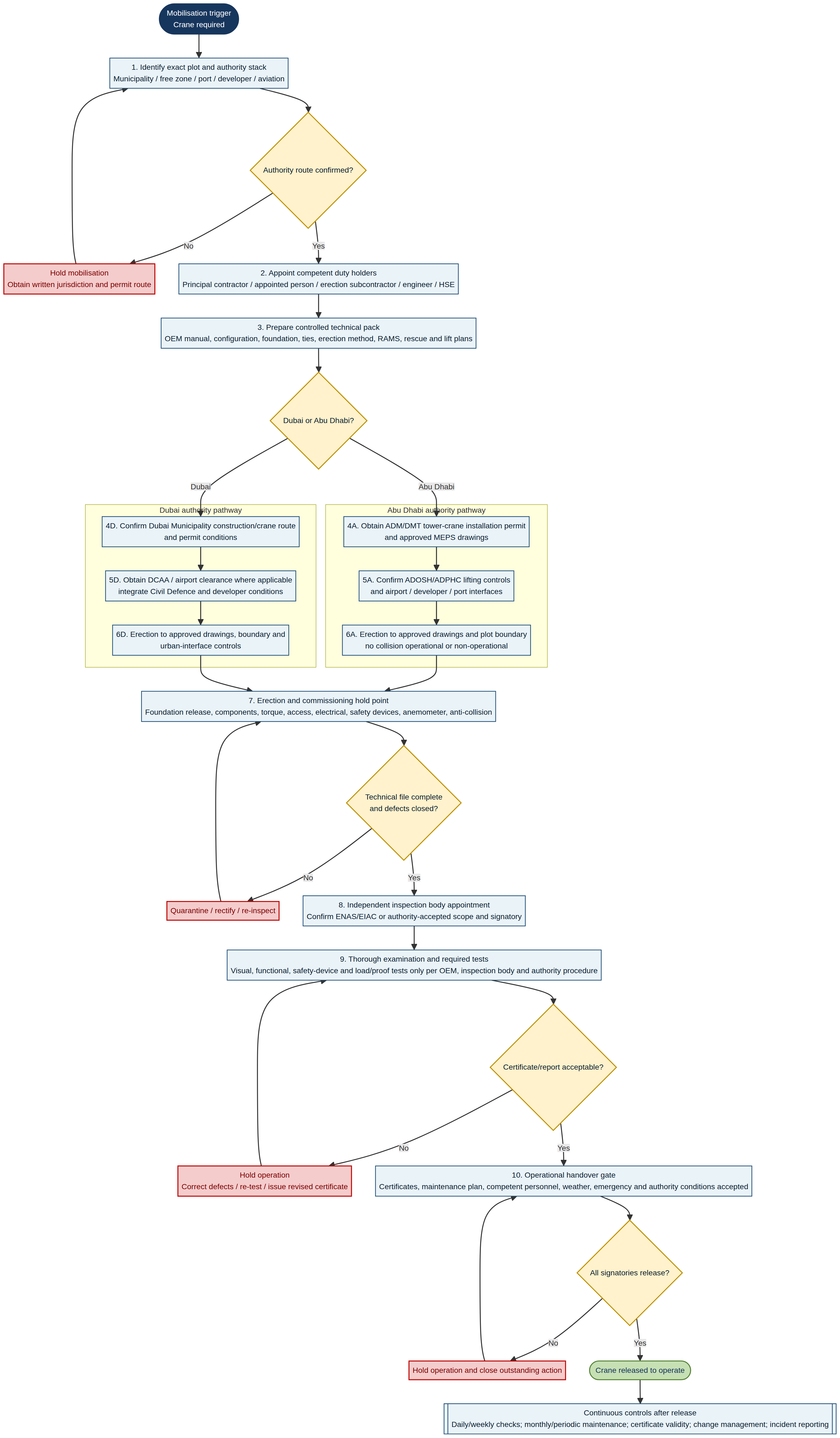

Erection, Approval and Certification Workflow diagramImage

One-page flow of the ten gates with the Dubai and Abu Dhabi branches, hold loops and the continuous controls that apply after release.

Presentation outline — Handover and Authority ApprovalMarkdown

A 13-slide, 45-minute facilitator outline for project managers, appointed persons, HSE leads, crane owners and inspection bodies, with speaker direction per slide.

Scope and limitations

  • This is a structured handover and evidence-control framework, not an erection, dismantling or load-testing method statement.
  • The manufacturer's current manual, the engineered foundation, tie, climbing and dismantling design, authority conditions, approved RAMS and the independent inspection body's requirements always prevail.
  • No crane may erect, climb, operate, dismantle or return to service on the strength of an incomplete checklist.
  • Dubai rows are written as confirmation gates: obtain the current Dubai Municipality, DCAA, Civil Defence, free-zone or developer condition for the exact plot before relying on any assumed threshold.

Next step

Turn this into evidence you can hand over

Replace scattered spreadsheets and WhatsApp threads with one HSE operations system built around UAE authority expectations.

  • Built around UAE authoritiesADOSH-SF, Trakhees, DM, DCD, MOIAT and ISO 45001 structures.
  • Usable the same dayTemplates and registers are pre-filled with your company details.
  • Evidence, not just formsEvery record carries dates, signatures and an export you can hand over.
